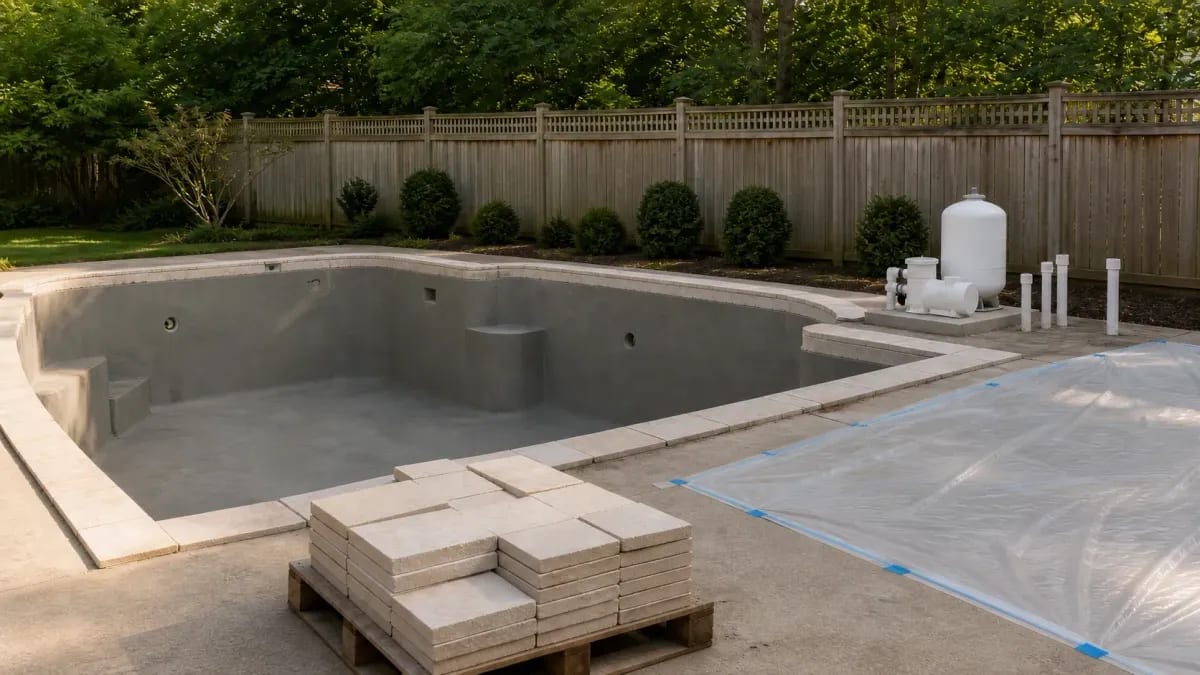

Pool Renovation & Remodel Cost: How to Build a Budget That Holds


How much does it cost to remodel a pool? In Northern Virginia, Montgomery County, and Washington, DC, a full pool remodel or renovation runs $15,000–$80,000+ at 2026 pricing, depending on how many elements you combine. Interior resurfacing on its own typically lands at $10,000–$26,000. An average 16×32 pool getting a mid-tier remodel — quartz interior, new waterline tile and coping, a deck overlay, and two equipment upgrades — comes to roughly $38,500–$68,100 once contingency and permits are included. Those are current figures, and the right starting point if you are planning a project this fall or winter for the 2027 swim season.
Notice that the number to plan around is not the quote. It is the quote plus 15–20% held back for conditions nobody can see until the old surface comes off, plus permits. That gap is where pool renovation budgets break. It usually isn’t because a contractor was dishonest. It is because most homeowners get one estimate, assume it covers everything, and then discover mid-project that the shell needed crack repair, or that chemical startup was never in the price. A budget built with the contingency already in it absorbs that. A budget built to the exact quote does not.
This guide turns a wide cost range into a number you can commit to: what each part of a remodel costs, what a real line-by-line budget looks like for an average pool, how to get quotes that are genuinely comparable, and how to finance the project. For a figure based on your own pool, try the pool renovation cost calculator. For costs broken down by pool size and finish, see our pool renovation cost guide for Virginia, Maryland, and DC. And if you are still deciding whether the work is needed at all, start with the signs your pool needs renovation or our guide to what a full pool renovation includes.
Pool Remodel & Renovation Cost at a Glance: 2026 Prices by Scope
“Remodel” and “renovation” describe the same job: replacing the worn parts of an existing inground pool — interior finish, tile, coping, deck, joints, equipment — rather than building a new one. Pricing is driven by surface area and perimeter, so the same scope costs meaningfully more on a big pool than a small one. These are the installed ranges we price pool renovation projects from in Northern Virginia, Montgomery County, and DC:
| Remodel scope | Typical project cost (2026) | Unit rate / what drives it |
|---|---|---|
| Full remodel (several scopes combined) | $15,000–$80,000+ | How many elements you combine, pool size, and finish tier |
| Interior resurfacing | $10,000–$26,000 | Plaster $12–$18, quartz $18–$25, pebble $24–$32 per sq ft |
| Waterline tile replacement | $3,500–$12,000 | Ceramic $40–$70, porcelain $55–$95, glass mosaic $70–$120 per linear ft of waterline, incl. old-tile removal and prep |
| Coping replacement | $6,000–$15,000 | $50–$160 per linear ft installed, by material |
| Deck resurfacing (overlay on the existing slab) | $3,000–$10,000 | $6–$14 per sq ft |
| Deck replacement (pavers, stone, or porcelain) | $13,000–$38,000+ | Pavers $25–$45, stone or porcelain $35–$55 per sq ft installed |
| Expansion-joint caulking reseal | $700–$2,000 | $8–$20 per linear ft; $1,200–$3,000 for a full-deck joint package |
| Water features | $2,000–$15,000+ for a waterfall or sheer descent | Deck jets $400–$1,200 each; bubblers $500–$1,500 each |
| Average 16×32 pool, mid-tier remodel (worked budget below) | $38,500–$68,100 | Includes 15–20% contingency and permits |
Equipment is usually bundled into a remodel because the labor overlaps: a variable-speed pump runs $1,800–$3,200 installed, LED lighting $900–$2,000 per fixture, a salt chlorine generator $3,000–$4,500, a gas heater or heat pump $5,000–$10,000, and automation $2,000–$4,000 for a mid-range system or $5,000–$10,000 for a premium controller. If adding a heater, lights, or automation means re-wiring the equipment pad and its bonding, budget renovation-scope electrical work at $3,500–$9,500+.
The finish you choose is the biggest single lever inside the interior line — our comparison of plaster vs. pebble vs. quartz pool finishes covers how each one looks, lasts, and ages, and the pool deck resurfacing cost guide breaks the deck line down by material.
One caveat governs everything above: these figures assume the shell is structurally sound. If the concrete substrate has significant cracking or delamination, structural repair has to happen before any new finish goes on — which is the single most common reason a renovation budget moves after work starts.
What Moves the Price in Northern Virginia, Montgomery County, and DC
Two pools of the same size can land thousands of dollars apart. Beyond size and finish tier, these are the local factors we see change a remodel number most often:
- Freeze-thaw damage at the edge. Our winters cycle above and below freezing, and water that gets behind failed caulk, loose coping, or cracked tile expands when it freezes. That is why a DMV remodel so often grows from “just resurfacing” into coping, waterline tile, and a joint reseal — the edge of the pool is where the damage shows first.
- Site access. Narrow side yards and tight gates — common on close-in lots in Arlington, Bethesda, and DC — mean demolition debris and new material move by hand or with small equipment, which adds labor. Sloped lots around Great Falls, McLean, and Potomac have the same effect.
- An existing automatic cover. New coping or a new deck usually means taking out deck-mounted cover tracks ($1,100–$1,600 for the removal; reinstalling tracks to keep the cover is priced separately). Retiring a cover that sits in a recessed box and filling the box in is a bigger line at $8,000–$10,000.
- Electrical on older equipment pads. Adding a heater, lighting, or automation to a pad that was never wired for them usually means new circuits and updated bonding — the $3,500–$9,500+ electrical line above. Ask whether it is in the quote or will arrive as a change order.
- Review calendars, not fees. Permit fees are a few hundred dollars, but historic districts and HOA architectural review add weeks before work can start — covered in the permits section below.
A Worked Budget: What an Average Renovation Actually Adds Up To
Component ranges are useful for orientation but hard to plan against. So here is a full budget built out for a real, common project: a 16×32 rectangular pool — about 510 sq ft of water surface and roughly 840 sq ft of interior surface (floor plus walls), a 96-foot perimeter, and about 600 sq ft of surrounding deck — getting a mid-tier renovation with quartz interior, porcelain waterline tile, new precast coping, a deck overlay, and two equipment upgrades.
| Line item | Basis | Cost |
|---|---|---|
| Interior resurfacing (quartz) | ~840 sq ft @ $18–$25 | $15,100–$21,000 |
| Waterline tile (porcelain) | 96 linear ft @ $55–$95, incl. old-tile removal and prep | $5,300–$9,100 |
| Coping replacement (precast concrete) | 96 linear ft @ $50–$90 | $4,800–$8,600 |
| Deck overlay (existing slab) | ~600 sq ft @ $6–$14 | $3,600–$8,400 |
| Expansion-joint reseal | 96 linear ft @ $8–$20 | $800–$1,900 |
| Variable-speed pump | Installed | $1,800–$3,200 |
| LED lighting | 2 fixtures @ $900–$2,000 | $1,800–$4,000 |
| Base scope subtotal | $33,200–$56,200 | |
| Contingency | 15–20% of base | $5,000–$11,200 |
| Permits (electrical; building if structural repair is needed) | Jurisdiction-dependent | $300–$700 |
| Plan for | $38,500–$68,100 |
Two things worth noticing. First, the spread on an identical scope is roughly $30,000 wide — material tier and pool size move the number far more than contractor choice does, which is why a quote that is dramatically below the others usually means a narrower scope, not a better deal. Second, water and chemical startup are deliberately not on this list, because whether they are included varies by contractor. Ask directly. On a 20,000-gallon refill plus a 7–14 day startup chemistry program, that is not a rounding error.
Want this worked out for your own pool? These are the same line items we price on a site visit. Request a pool renovation quote and we will walk the pool with you, measure it, and give you an itemized number — or run your own size and finishes through the renovation cost calculator first.
How to Get Accurate, Comparable Quotes
The most common mistake homeowners make is comparing quotes that don’t cover the same scope. One contractor includes tile removal and disposal; another doesn’t. One quote includes chemical startup; the other ends at pool fill. On otherwise identical projects those differences easily represent thousands of dollars — and they make the cheapest quote look like the best one.
- Provide a written scope first. Before calling contractors, write down exactly what you want: which interior finish, which coping material, deck square footage, which equipment to replace. Identical scope in means comparable pricing out. Without it you are not collecting quotes, you are collecting guesses.
- Ask what is explicitly excluded. Get the exclusions in writing. Specifically: does this include demolition and disposal? Permits and inspection coordination? Water and chemical startup? Structural repair if the shell turns out to need it, or is that a change order?
- Ask how structural surprises get priced. This is the question almost nobody asks. Find out now, in writing, what the rate is for crack repair or plumbing work discovered after demolition — before you have a drained pool and no leverage.
- Get at least three quotes. One quote is a number; three quotes are a market. It also surfaces the scope gaps — when one bid comes in thousands below the others, comparing line items tells you what it left out.
- Verify licensing in your jurisdiction. Virginia contractors are licensed through the Department of Professional and Occupational Regulation (DPOR) — a pool renovation of this size needs a Class A or Class B license. Maryland uses a state-level Maryland Home Improvement Commission (MHIC) license, not a county-by-county system. DC licenses separately again, which matters if your contractor works across the region. Beltway Pools holds all three.
If you are early in vetting, our guide to choosing a pool contractor covers what else to check beyond price.

Build the Contingency In Before You Sign
Until the old surface and deck are removed, nobody — including your contractor — knows exactly what is underneath. Budget 15–20% above your base quote and treat it as part of the project cost, not as optional extra savings. The distinction matters: a contingency you have already mentally spent lets you approve necessary work in a day. A contingency you have not funded turns a routine structural repair into a stalled project with a drained pool sitting in your yard.
What actually gets found, in rough order of frequency: surface delamination behind intact-looking plaster, hairline shell cracks that only show once the finish is chipped off, corroded or undersized embedded fittings and returns, expansion-joint damage under old caulk, and plumbing that has been weeping quietly behind the wall. What any of it costs depends entirely on what turns up, which is exactly why the reserve exists. On the worked budget above, 15–20% is $5,000–$11,200 set aside before the first tile comes off — money that lets a discovery be approved in a day rather than financed in a hurry.
You can shrink the unknowns before you collect quotes. A flat-rate pool inspection ($450) documents the condition of the shell, interior surface, deck, plumbing, and equipment in a written report with photos. It cannot see behind plaster that is still intact, but it does turn visible cracks, leaks, and failing equipment into line items you can price up front instead of surprises you pay for mid-project.
One related caution: do not drain the pool yourself to inspect the shell before getting quotes. Hydrostatic pressure from groundwater can lift or crack an empty gunite shell, and that turns an inspection into the most expensive line item in the project. Draining is part of the contractor’s scope for a reason.
Sequence the Money in the Right Order
If your budget will not cover everything you want, the order you spend in matters more than the total. Structural and mechanical work comes first, surfaces second, aesthetics last. A new quartz interior over a failing pump or deteriorating plumbing is money spent twice, because reaching that plumbing later means breaking into work you just paid for.
The practical sequence:
- Structural repair and plumbing — anything that lives behind or beneath a finish
- Equipment — pump, filter, heater, automation; all of it is easier with the pool already down
- Interior resurfacing, waterline tile, and coping — the elements that share draining and mobilization
- Deck and hardscape
- Water features and aesthetic upgrades
Bundling Genuinely Saves Money
Combining elements in one project costs less than doing them separately, and the reason is specific rather than a discount: resurfacing and coping share the same drain-down, mobilization, and cleanup, so you pay for those once instead of twice. Tile sits at the intersection of the interior and the coping, so doing it with either avoids cutting into finished work. Equipment replacement bundled with automation shares the electrical labor. Ask your contractor to price the bundle and the pieces separately so you can see the actual difference.
Phasing Across Two Seasons
Phasing is a legitimate strategy if the total is out of reach this year, but it has to follow the sequence above rather than your preferences. A workable two-phase split is structural, plumbing, equipment, and interior resurfacing in year one; deck, coping, and features in year two. What does not work is resurfacing first and deferring the structural repair, or finishing the deck before the coping it has to meet. Phasing also means paying mobilization and draining twice, so expect the two-phase total to run above the single-project total — you are buying time, not savings.
Permits and HOA Review: Budget the Calendar, Not Just the Fee
Whether you need a permit depends on scope. Cosmetic work — resurfacing, tile, coping on an existing structure — often does not require one. Structural repair, new or altered plumbing and electrical, deck construction, and added water features generally do, and a separate electrical permit is typically required alongside the building permit.
The fee itself is usually a modest line item rather than a budget risk — hundreds of dollars, not thousands. For scale, Montgomery County’s FY27 fee schedule (effective July 1, 2026) lists a permit for a brand-new residential in-ground pool, fence included, at $360.68, and Fairfax County’s minimum fee for any building, electrical, or plumbing permit is $141.75, plus a 2% state Code Academy levy and a 10% technology surcharge. Exact fees depend on jurisdiction and scope, and your contractor should be pulling and coordinating the permits as part of the project.
The real budget impact is time. Standard residential review runs 3–6 weeks in most Northern Virginia jurisdictions and 4–8 weeks in Montgomery County and DC. Historic districts — Georgetown, Chevy Chase, Old Town Alexandria, parts of Bethesda and Kensington — add further review on top of that. If your HOA runs an architectural review committee, add another 2–4 weeks before you can even submit. Our pool permits guide breaks down the requirements by jurisdiction. None of that changes what the renovation costs, but it absolutely changes when you can swim, and a project that misses its window can end up carrying costs into another season.
Timing: What Booking Off-Season Actually Gets You
Booking a renovation for fall or winter is genuinely advantageous, but be clear about why — the benefit is scheduling leverage and crew availability, not a guaranteed seasonal discount. Off-peak, you get earlier start dates, more flexibility on the calendar, and a permit review that is not competing with the spring rush. You also get better curing conditions for plaster in fall than in high summer heat, though hard freezes pause work and plaster application needs a 40°F minimum, with 50°F+ preferred.
Practically, a permitted renovation is a 3–4 month proposition end to end once review time is included. Booking in October or November is comfortable for a pool that has to be swim-ready by Memorial Day; mid-January is a realistic last call. Our guide to the best time to renovate your pool works through the seasonal tradeoffs and timeline in detail, and if you are weighing it right now, should you renovate your pool this fall covers the decision.
Where DIY Actually Helps
A few tasks can reasonably be self-performed to trim cost: clearing and prepping the work zone, removing furniture and old equipment, and landscaping repair afterward. Interior finishing, plumbing, electrical, and structural work should not be — not only because of licensing and permit requirements, but because the longevity of a finish depends on surface prep and application technique that is difficult to get right once. A resurfacing that fails early costs far more than the labor it saved.
Financing a Renovation
If you are not paying cash, there are three realistic paths:
Home Equity Loan or HELOC
The standard tool for home improvement. A home equity loan is a lump sum at a fixed rate; a HELOC works as a revolving line with a draw period, which suits a phased renovation well because you draw only as each phase bills. Both are secured by your home, so rates are typically lower than unsecured borrowing — and your home is the collateral if payments are missed. In the DMV, where home values are high, most owners of an established pool have meaningful equity to work with.
Personal Loans
For smaller projects or homeowners with limited equity, an unsecured personal loan avoids putting the house up. Rates run higher, but approval and funding are faster than a HELOC — useful if a structural discovery mid-project means you need funds in days rather than weeks.
Pool-Specific Financing
Beltway Pools works with Lyon Financial, a pool-lending specialist for over 40 years, which offers fixed-rate terms of up to 30 years on qualifying projects. Because the lender understands pool work, the underwriting tends to be more straightforward than a general home-improvement product. Compare the rate and total interest against your equity options rather than only the monthly payment — a longer term lowers the payment and raises the total cost. See our financing page for current options.
Whichever route you take, get the financing arranged before demolition, and size it to the contingency-inclusive total rather than the base quote. A funded contingency is what keeps a change order from becoming a stopped project.
Frequently Asked Questions
How much does it cost to remodel or renovate a pool in Virginia, Maryland, or DC?
A full pool remodel in Northern Virginia, Montgomery County, and DC runs $15,000–$80,000+ at 2026 pricing, depending on how many elements you combine. Interior resurfacing on its own is typically $10,000–$26,000. An average 16×32 pool getting a mid-tier remodel — quartz interior, waterline tile, new coping, deck overlay, and two equipment upgrades — has a base scope of $33,200–$56,200 and lands around $38,500–$68,100 once a 15–20% contingency and permits are included. Our pool renovation cost guide breaks the pricing down by pool size and finish; compare its per-size ranges with the base scope, not the all-in figure.
How much does it cost to remodel a pool versus just resurfacing it?
Resurfacing alone — a new interior finish on a sound shell — is $10,000–$26,000. A full remodel that also replaces coping, waterline tile, and the deck, and upgrades equipment, is roughly two to three times that. The reason people bundle rather than resurface in isolation is that coping and tile sit directly against the interior finish, so doing them later means cutting into work you just paid for. If you only need the interior addressed, check the signs your pool surface needs refinishing first.
What does a pool remodel cost per square foot?
It depends on the surface, because a remodel is priced line by line rather than at one blended rate. Interior finishes run $12–$18 per sq ft for plaster, $18–$25 for quartz, and $24–$32 for pebble. A deck overlay on the existing slab is $6–$14 per sq ft, while a new deck runs $25–$45 per sq ft for pavers and $35–$55 for natural stone or porcelain, installed. Waterline tile is priced by the linear foot of waterline, including old-tile removal and prep: $40–$70 for ceramic, $55–$95 for porcelain, and $70–$120 for glass mosaic. Coping is also priced by the linear foot, at $50–$160 depending on material. Add up the lines your project needs, then hold 15–20% back for contingency — or let the renovation cost calculator do the math for your pool size.
Is it worth renovating an older pool instead of building a new one?
For a pool with a structurally sound shell, renovation is dramatically more cost-effective. The mid-tier remodel of an average 16×32 pool worked through in this guide comes to $38,500–$68,100 all-in, while a new gunite build in the DMV starts around $115,000. The math only shifts toward replacement if the shell has genuine structural failure or the pool’s size and location no longer work for the property. Our guide to pool repair versus renovation helps place your pool on that spectrum.
How much should I hold back for contingency?
15–20% of the base quote, funded before work starts — $5,000–$11,200 on the average-pool budget in this guide. Structural repair discovered after the old surface is removed is the most common overrun, and nobody can price it until the finish is off. Treat the contingency as part of the project cost rather than as savings you hope to keep — the point is being able to approve necessary work immediately instead of pausing a project with a drained pool in the yard.
What's the most common unexpected cost in a pool renovation?
Structural repair found after demolition, by a wide margin. Surface delamination behind intact-looking plaster, hairline cracks in the shell, corroded embedded fittings, and plumbing weeping behind the wall are all common and effectively invisible until the finish comes off. The second most common is a scope gap the homeowner did not catch — usually water and chemical startup, or demolition disposal, quietly excluded from the quote.
Can I renovate my pool in phases to spread out the cost?
Yes, provided the phases follow the right order: structural, plumbing, equipment, and interior resurfacing first; deck, coping, and features second. What does not work is resurfacing before structural repair, or finishing a deck before the coping it has to meet. Be aware that phasing means paying draining and mobilization twice, so the two-phase total runs above the single-project total. You are buying time, not savings.
Do I need a permit to renovate my pool, and what does it cost?
It depends on scope. Purely cosmetic work — resurfacing, tile, coping on an existing structure — often needs no permit. Structural repair, new or altered plumbing and electrical, deck construction, and added water features generally do, usually with a separate electrical permit. The fee is modest — a few hundred dollars in most DMV jurisdictions — but review time is the real planning constraint: 3–6 weeks in most of Northern Virginia and 4–8 weeks in Montgomery County and DC, with historic districts adding more. See our pool permits guide.
Is fall or winter renovation actually cheaper?
Not reliably cheaper, but easier to schedule. The genuine off-season benefits are earlier start dates, more crew flexibility, permit review that is not competing with the spring rush, and better plaster curing conditions than midsummer heat. Plaster application needs a 40°F minimum with 50°F+ preferred, and hard freezes pause work. Budget on scope rather than on an expected seasonal discount — see the best time to renovate your pool.
The Short Version
- Plan on $15,000–$80,000+ for a full pool remodel or renovation in Northern Virginia, Montgomery County, and DC at 2026 pricing; interior resurfacing alone is $10,000–$26,000. An average 16×32 pool with a mid-tier remodel comes to roughly $38,500–$68,100 all-in. Scope and pool size drive the number far more than contractor choice.
- Budget the quote plus 15–20%, not the quote. Structural repair found after demolition is the most common budget-breaker, and nobody can price it until the old surface is off.
- Compare scope, not prices. Get exclusions in writing, and settle now how post-demolition surprises get priced.
- Spend in order: structural and plumbing, then equipment, then interior and coping, then deck, then features. Anything that lives behind a finish goes first.
- Bundle where the labor overlaps — shared draining and mobilization is a real saving. Phasing buys time, not money.
- Book off-season for scheduling leverage, not for a discount. A permitted renovation is 3–4 months end to end; October–November booking is comfortable for a Memorial Day swim.
Ready to Put a Real Number on It?
Beltway Pools scopes and budgets pool remodels for homeowners across Northern Virginia, Montgomery County, and Washington, DC. We will walk the pool with you, tell you honestly what needs doing now versus what can wait a season, and give you an itemized quote you can actually compare — including how any structural surprises would be priced.
Start with the pool renovation cost calculator for a figure based on your own pool, explore our renovation services, or request a renovation quote to get a real assessment of what your project will cost.
